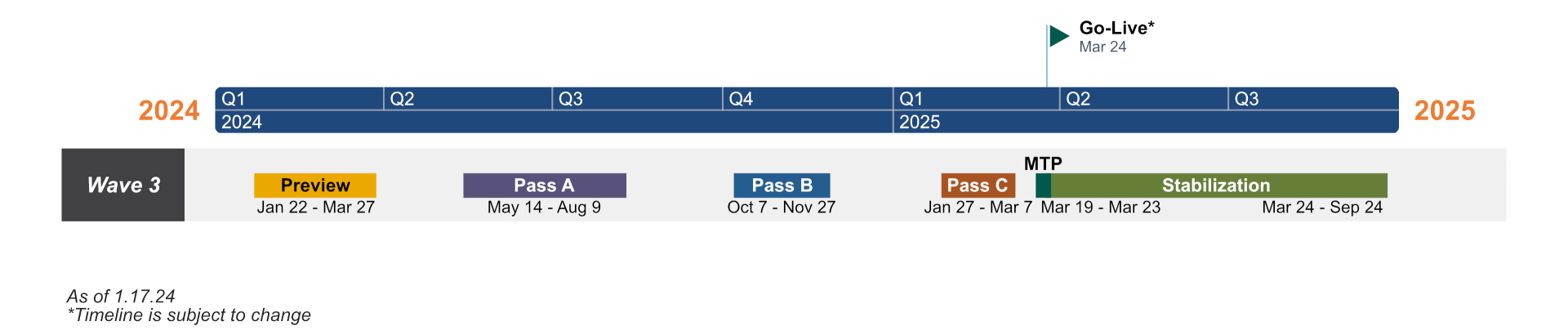

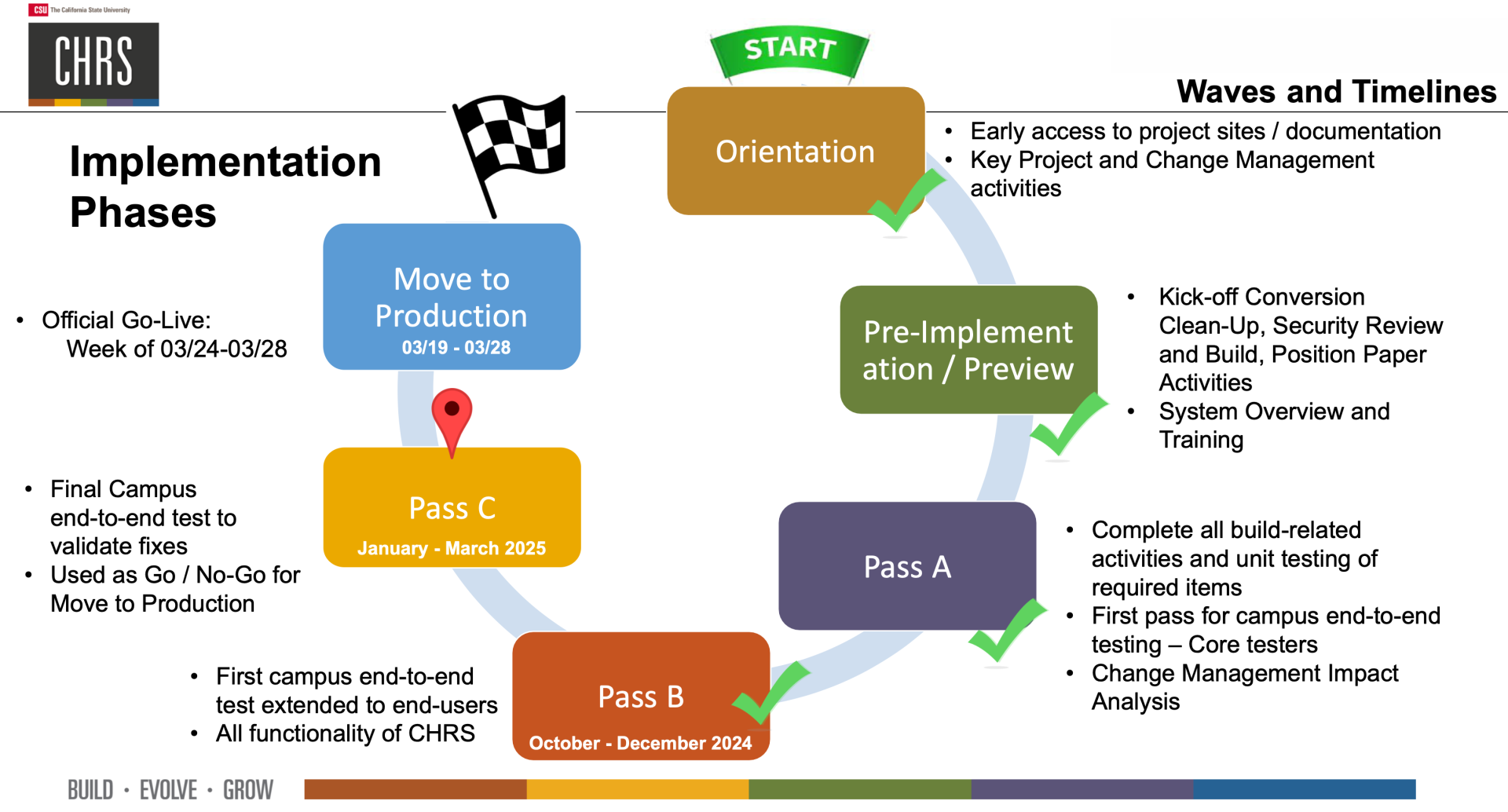

CHRS Wave 3 Timeline

CSUSB is a part of the CHRS wave 3 implementation along with other CSUs. The timeline for implementation is as follows:

Project kick off

  • CHRS team comes together and the work begins
  • April 2023

Pre-implementation work

  • Conversion clean-up, Position Paper implementation, security review, and integration discussions
  • April 2023 - October 2023

Preview Pass

  • Setup for security
  • Review of test scripts and change impact analysis
  • January 2024 - March 2024

Testing Pass A

  • Complete all build-related activities and unit testing of required items for core testers
  • First pass for campus end-to-end testing
  • May 2024 - August 2024

Testing Pass B

  • Campus end-to-end test for end-users
  • October 2024 - November 2024

Testing Pass C

  • Final campus end-to-end test to validate fixes
  • Go/No-Go for Move to Production
  • January 2025 - March 2025

Move to Production

  • System go live
  • March 2025

Stabilization

  • Ongoing monitoring of system functionality
  • March 2025 - September 2025
